Construction and development timeline.

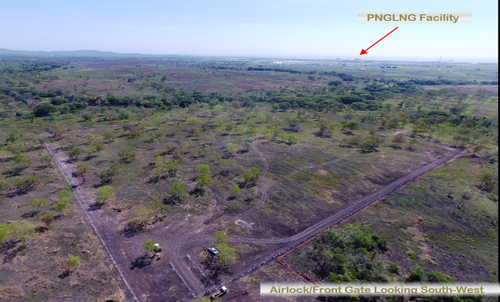

Pre-construction aerial photograph of Portion 2740 where the Port Moresby Power Plant will be constructed.
Ground-breaking ceremony with Minister of State Enterprise, Mr. William Duma.
Ground clearing, land preparation, grading and compaction of site office area at the power plant site.
Capping of permanent areas including engine hall. Construction of site Project Management Office and profile marking of engine plinths.
Earth grid works commences on power station perimeter, concrete pour on engine plinths, installation of underground oily water & fire water lines.
Switchyard concrete pours on 11/66kV transformer bunds, engine hall installation of structural supports.
Engine hall wall panel installation on Northern & Western end and first layer of roof panel installation.
Exhaust stack installed six exhaust gas silencers.
CAPE preparatory works for insulation of exhaust stack silencers. Complete installation of switchyard equipment.
Black start unit installation onto bay, control room cable haul and pull, switchyard installation MV 11kV cables to transformer.
Gas supply piping from PNG LNG being constructed.
